I-96/Grand River Avenue Interchange Rebuilding Project - Livingston County
About this project

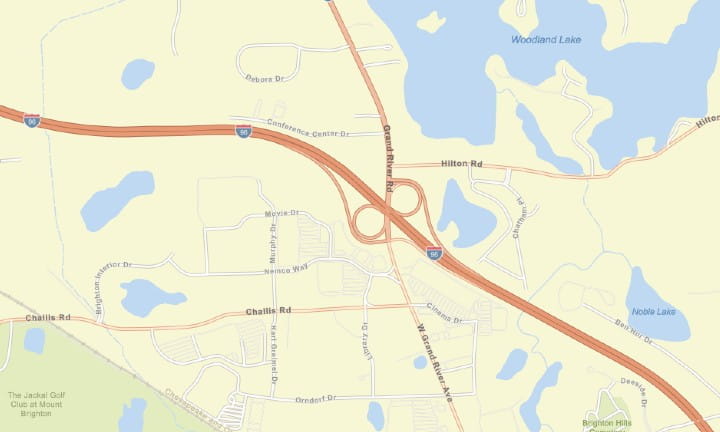

The I-96/Grand River Avenue interchange project involves rebuilding the interchange as a diverging diamond interchange (DDI). As part of the project, two structures will be replaced along I-96. Those include the two I-96 bridges over Grand River Avenue. The planned improvements to the interchange will require acquiring additional right of way.
Planned work
- Rebuild I-96 bridges over Grand River Avenue.
- Rebuild approximately 0.7 miles of I-96 approaches to accommodate bridge replacements.
- Rebuild and reconfigure ramps at the Grand River Avenue interchange as a DDI.
If you require assistance accessing project files and drawings or require them in an alternative format, contact Jack Rick.
Project details
Fall 2024
2026
Schedule
Location
Livingston County
Cost
$45 million
Benefits
- Increased safety
- Reduced congestion
Project stages
-

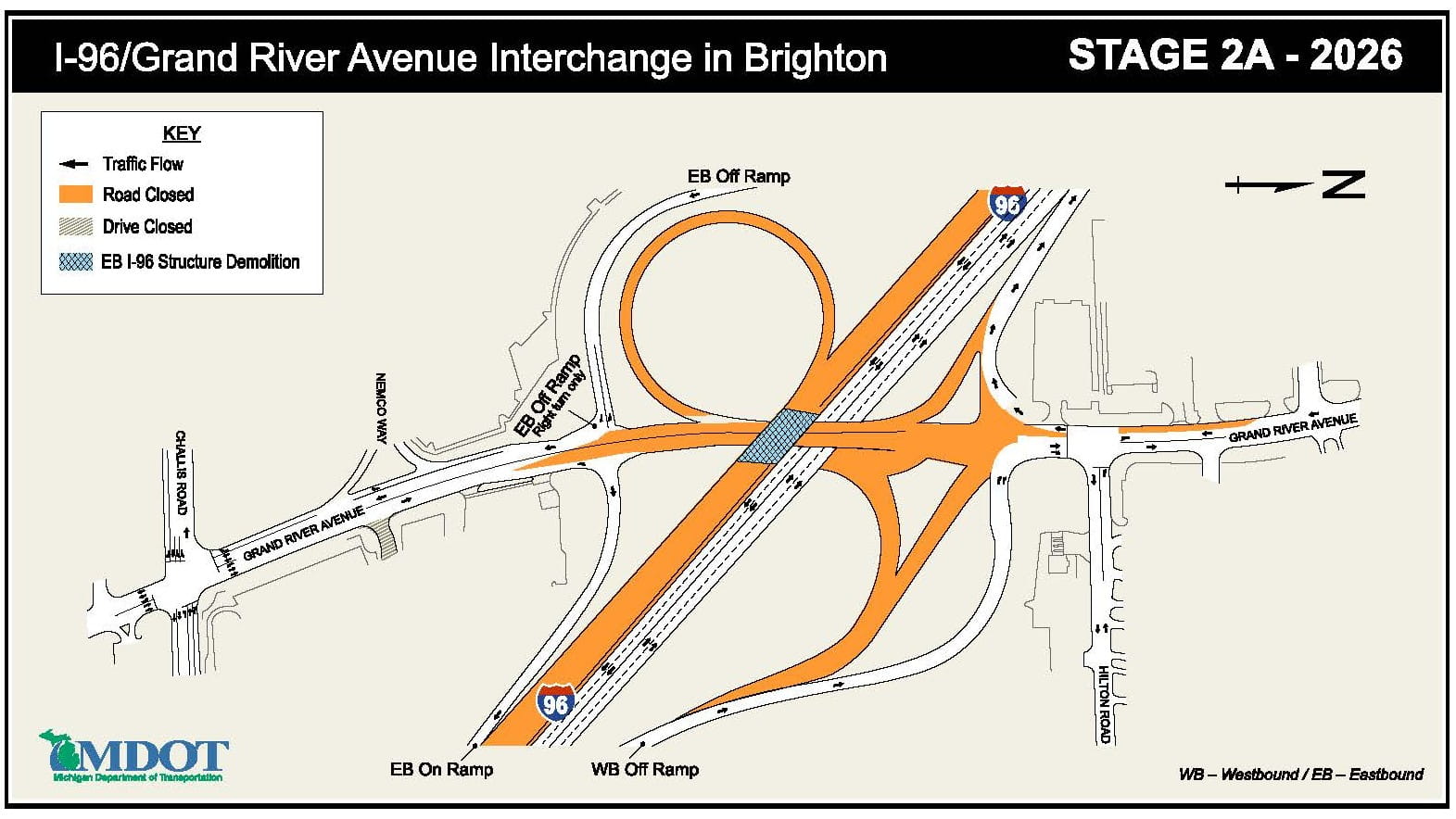

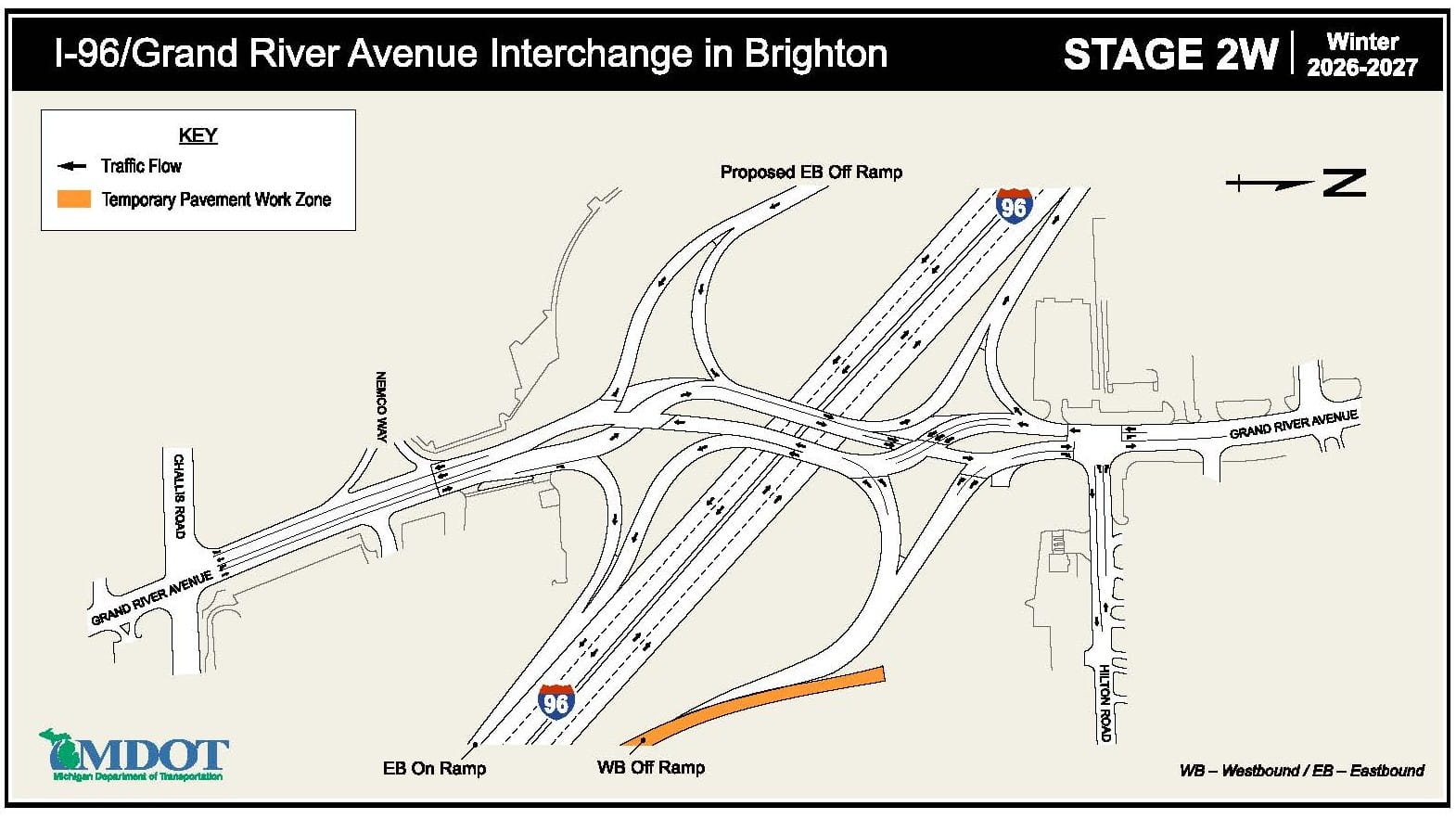

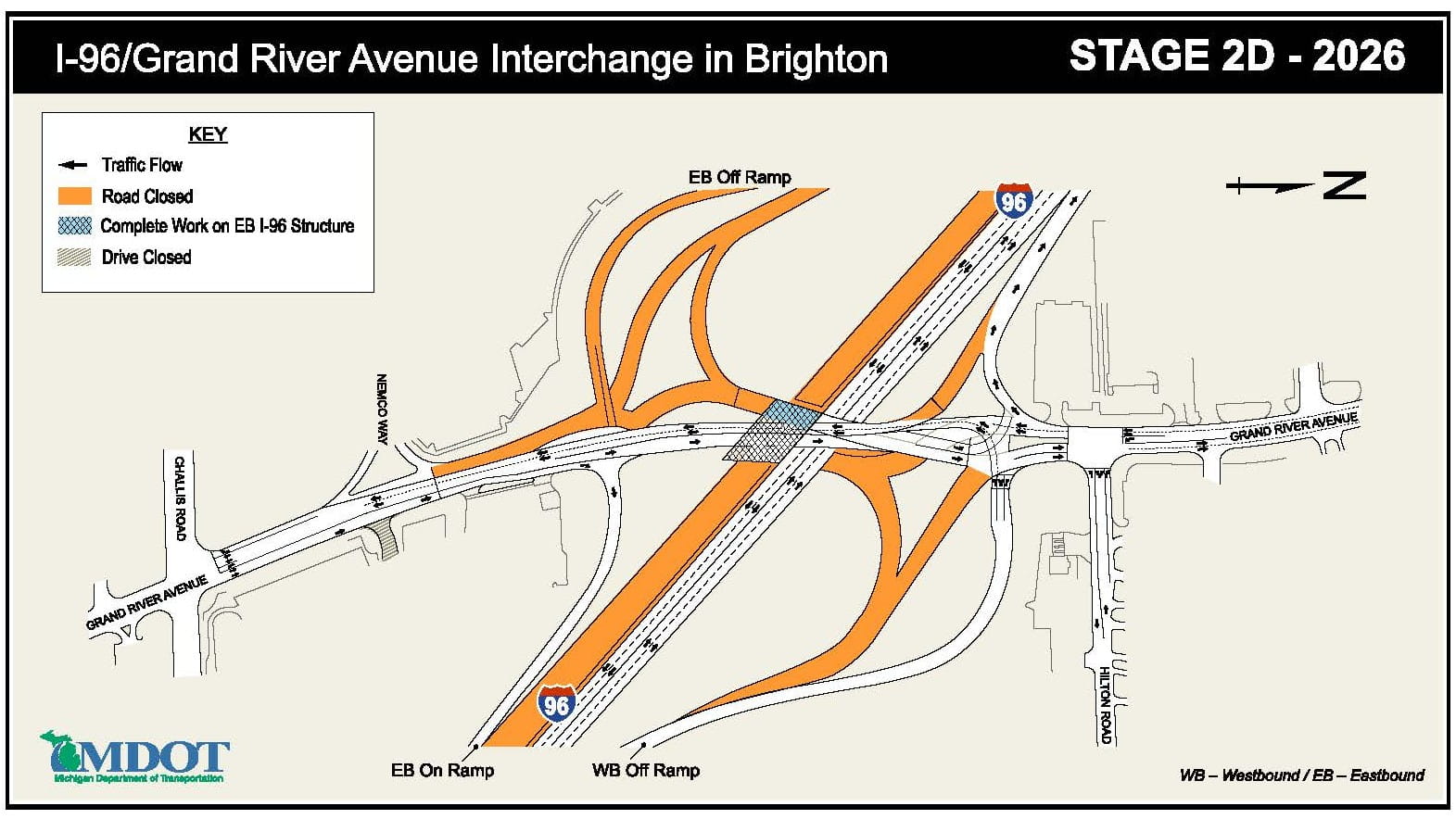

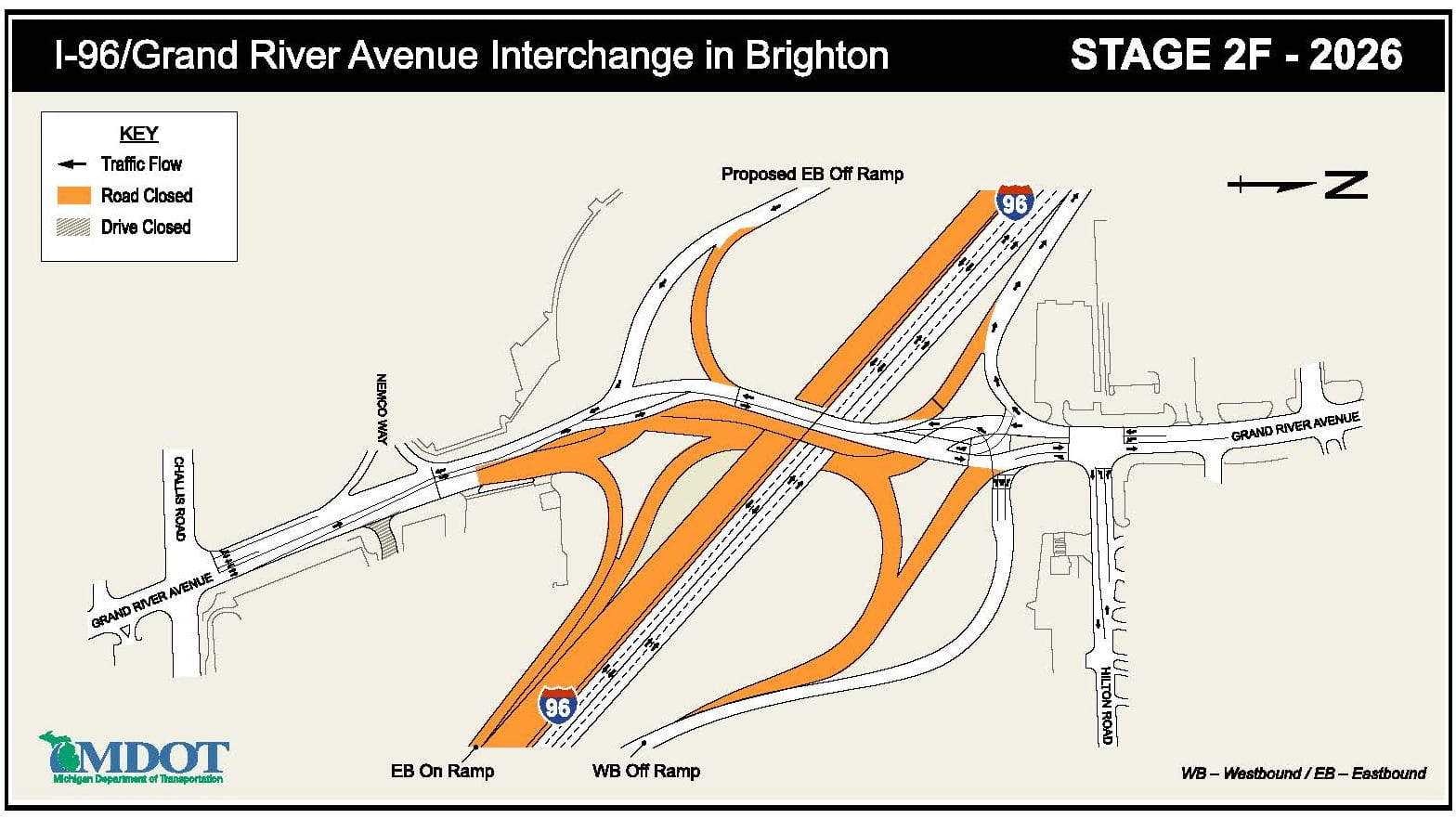

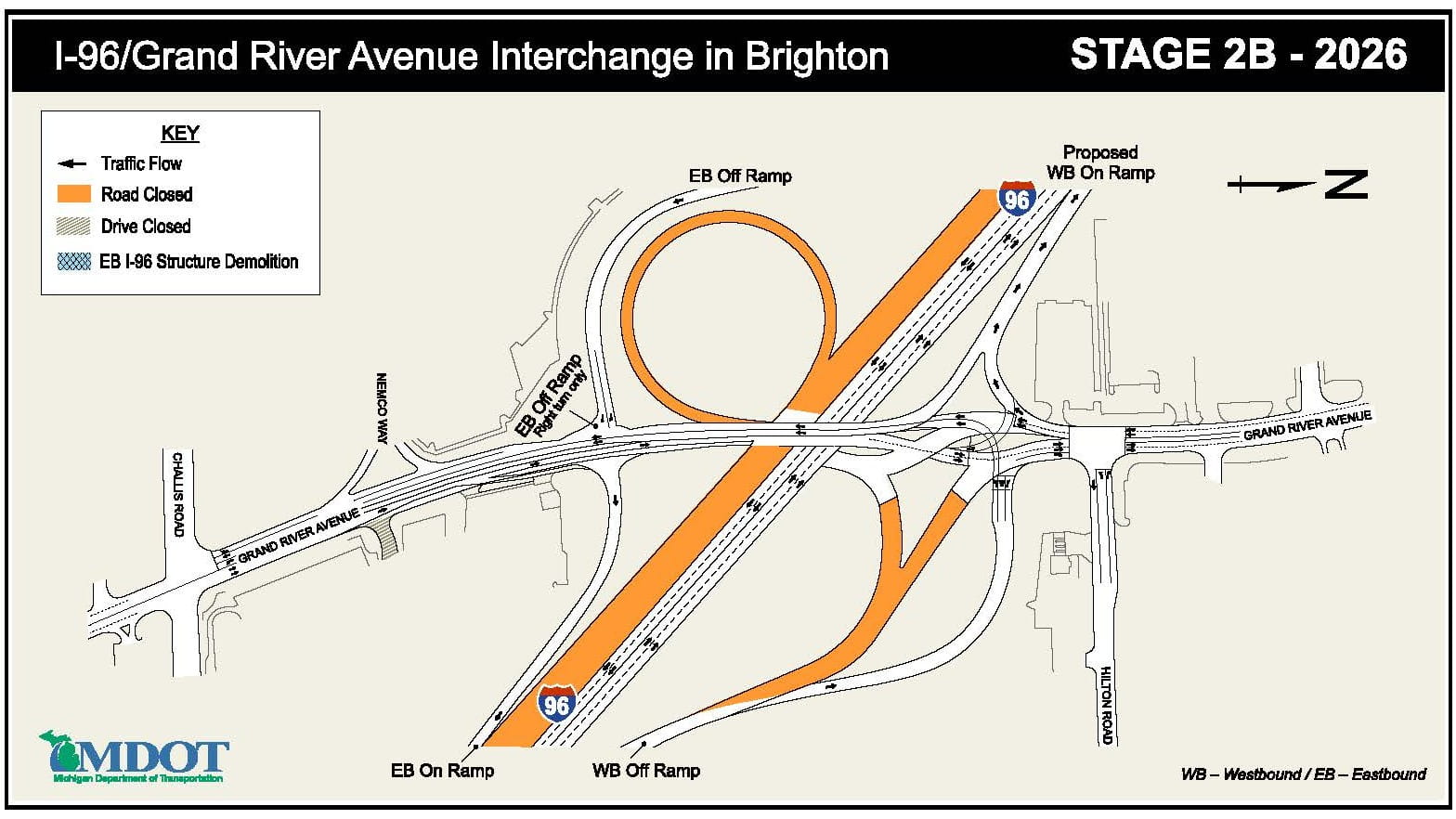

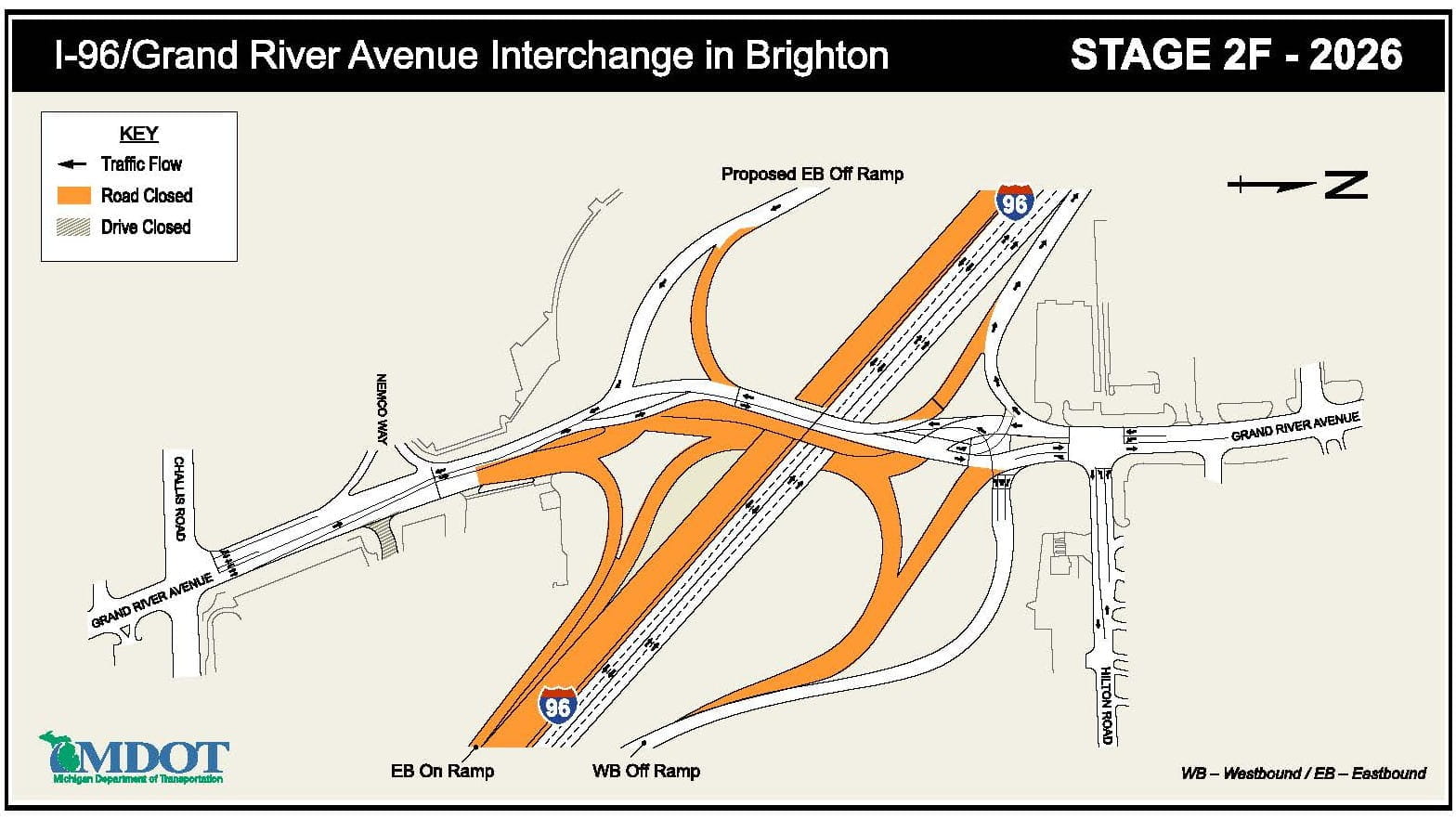

2026 Construction
- Rebuild eastbound I-96.
- Two lanes of eastbound and westbound I-96 traffic will be maintained on westbound I-96.

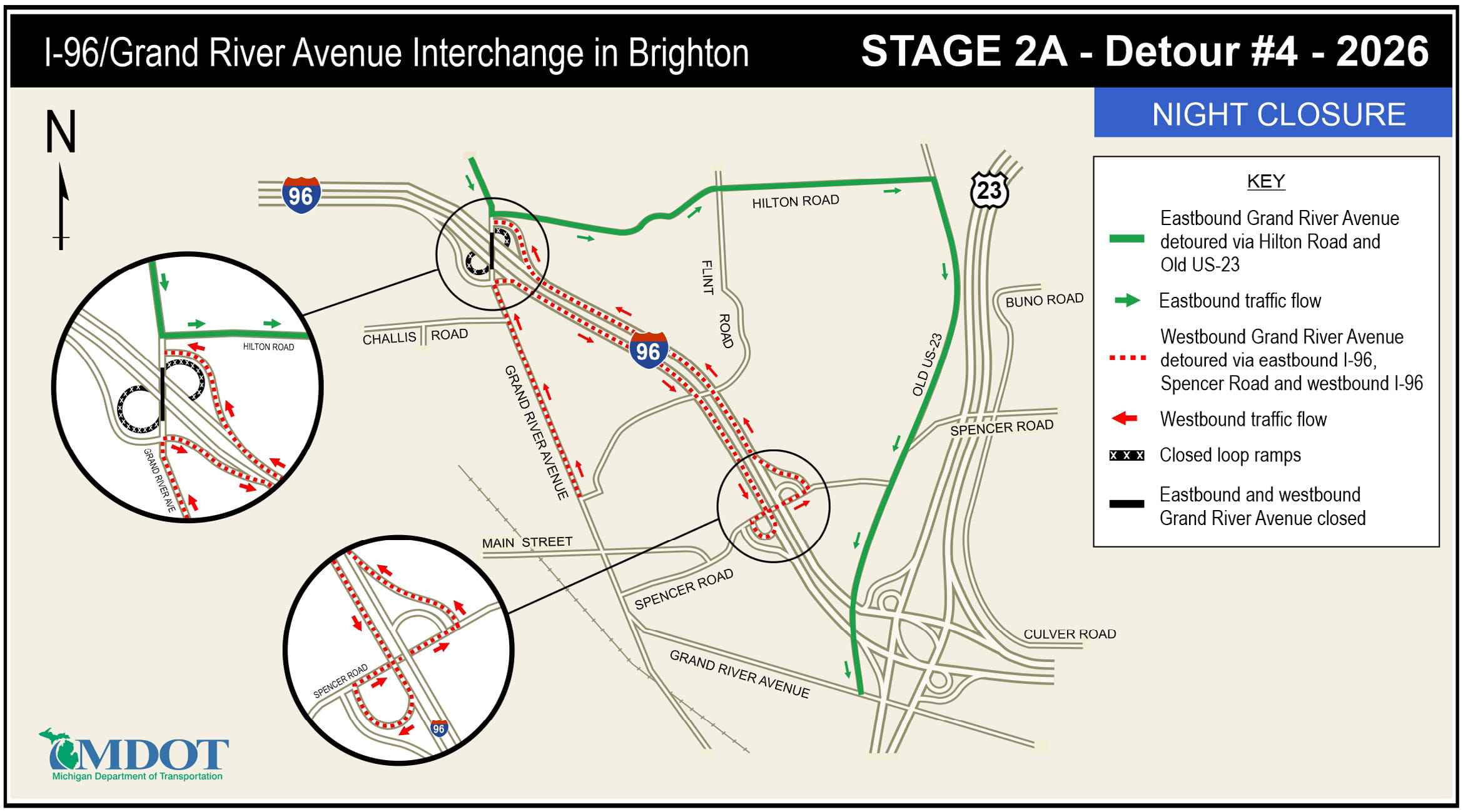

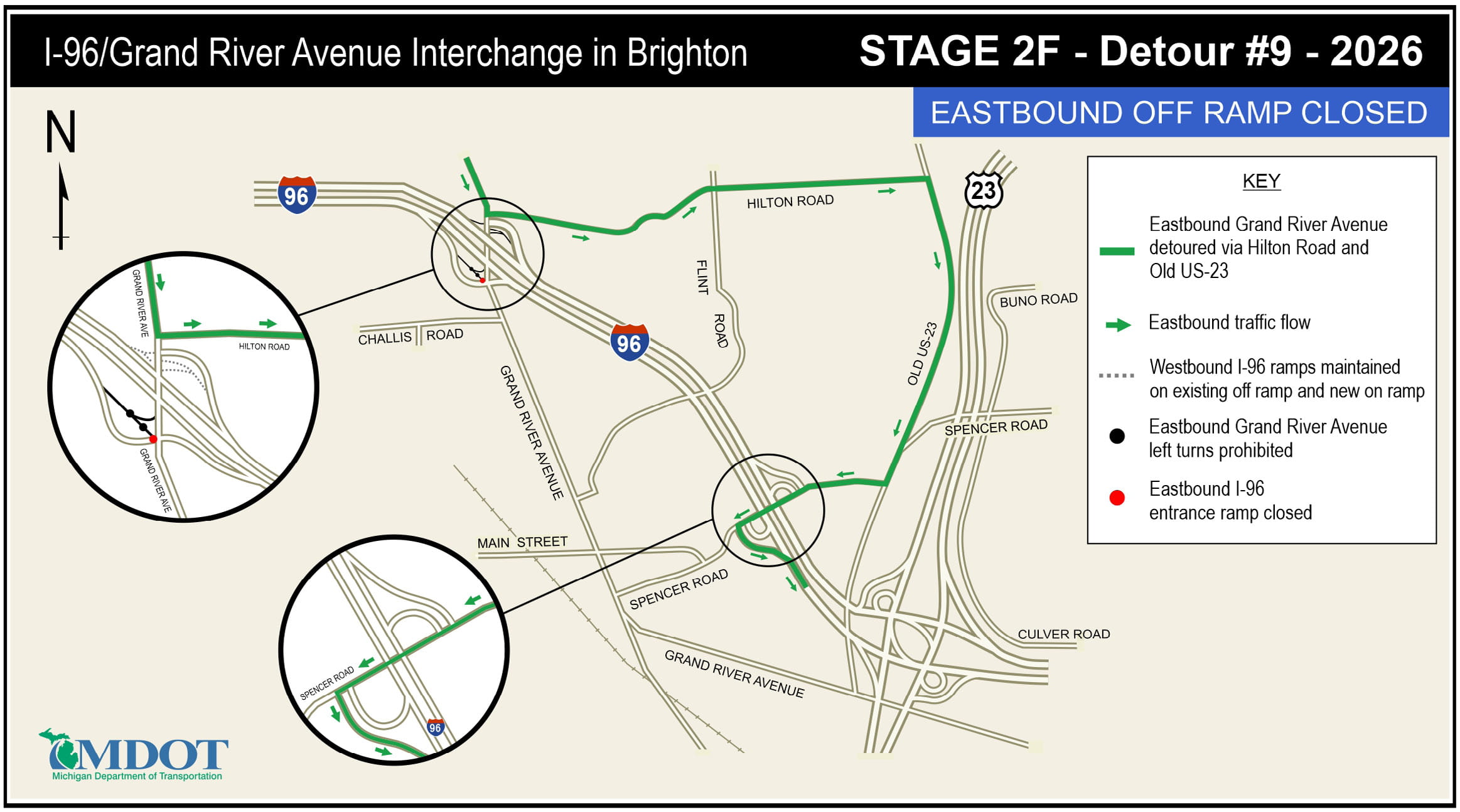

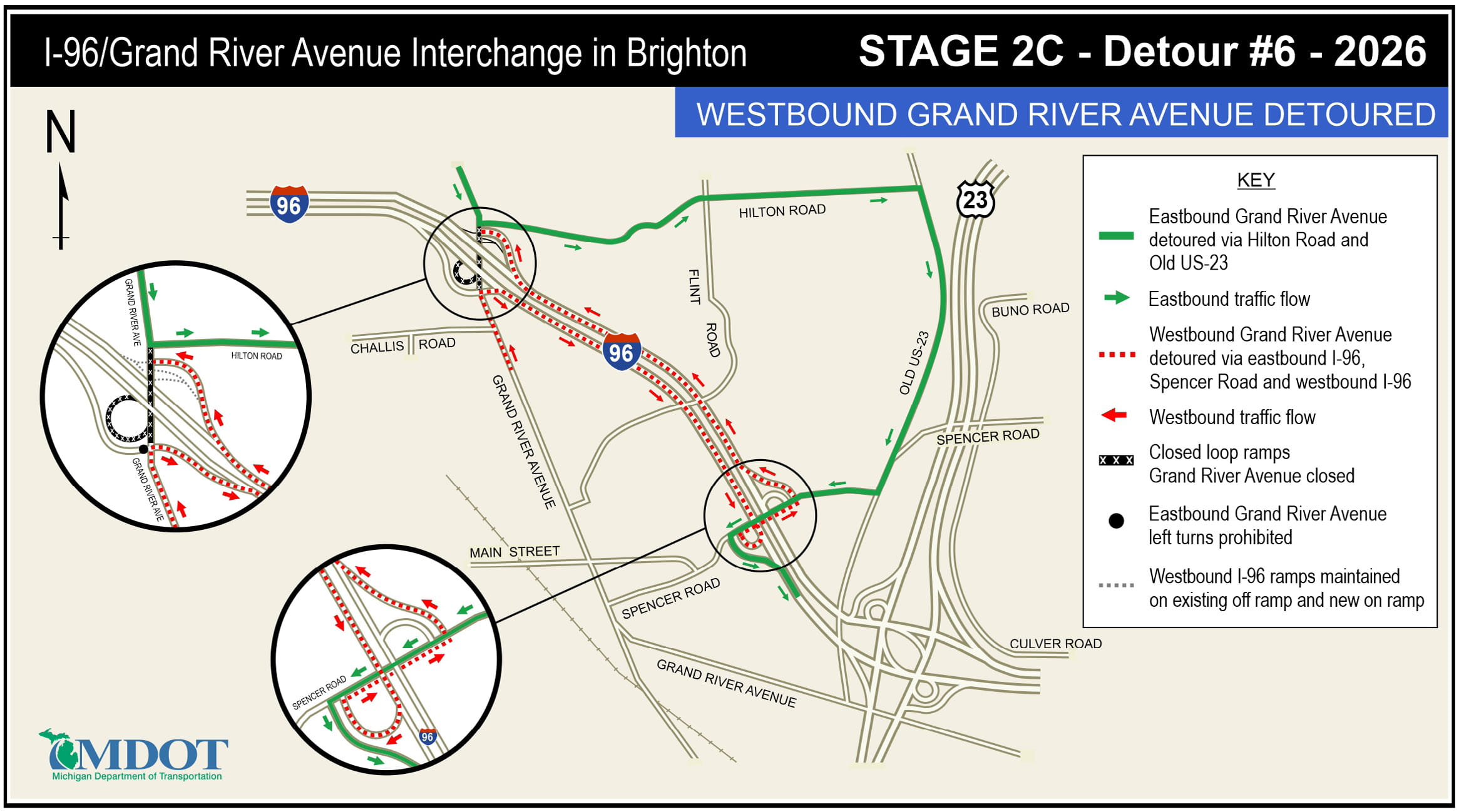

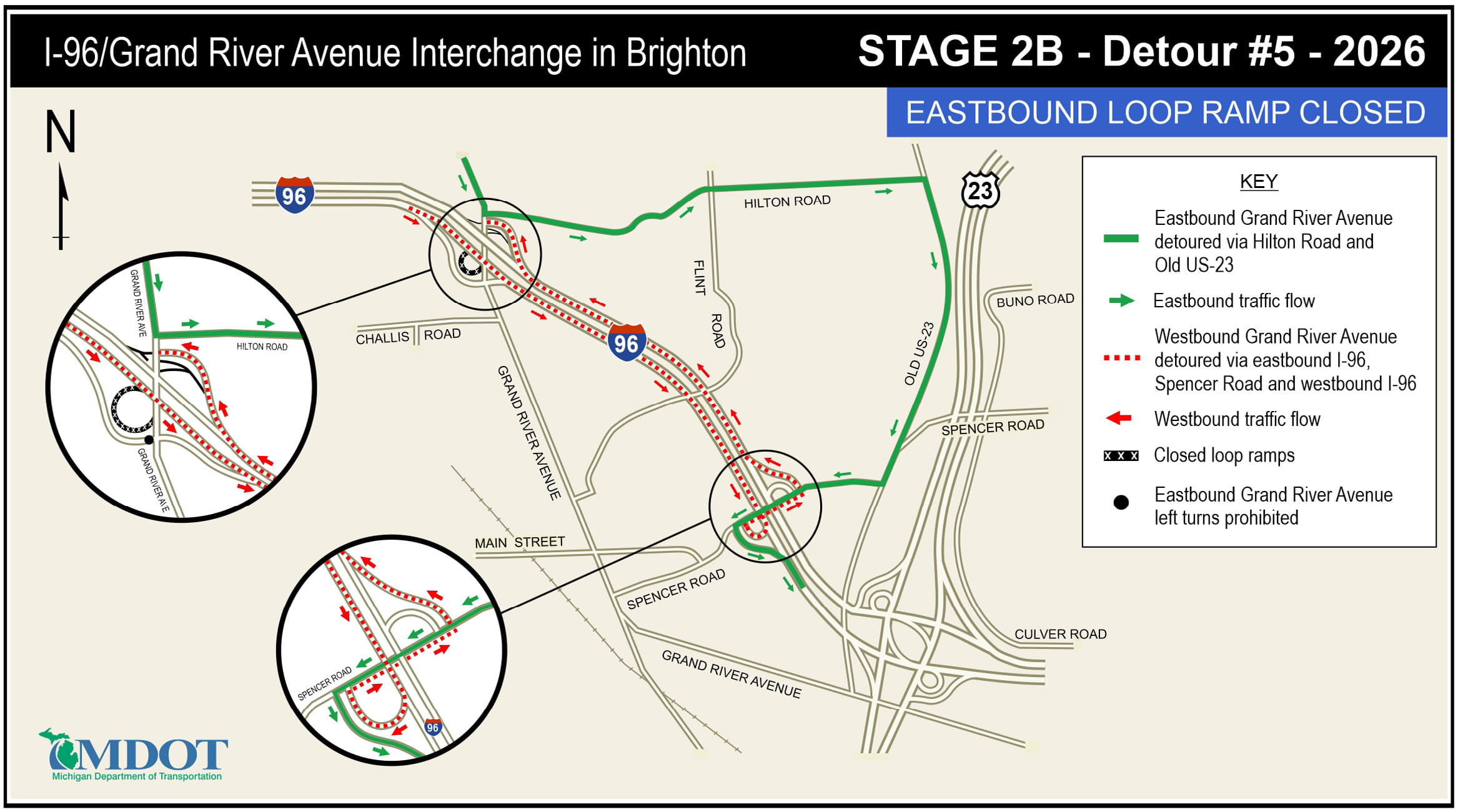

- Rebuild the Grand River Avenue ramps in various stages. Primary detours are:
- Westbound Grand River Avenue to eastbound I-96, then Spencer Road to westbound I-96.
- Eastbound Grand River Avenue to Hilton Road, then Old US-23 to Spencer Road to westbound I-96.
- I-96/Grand River Avenue interchange update (February 2026)
- Rebuild eastbound I-96.
-

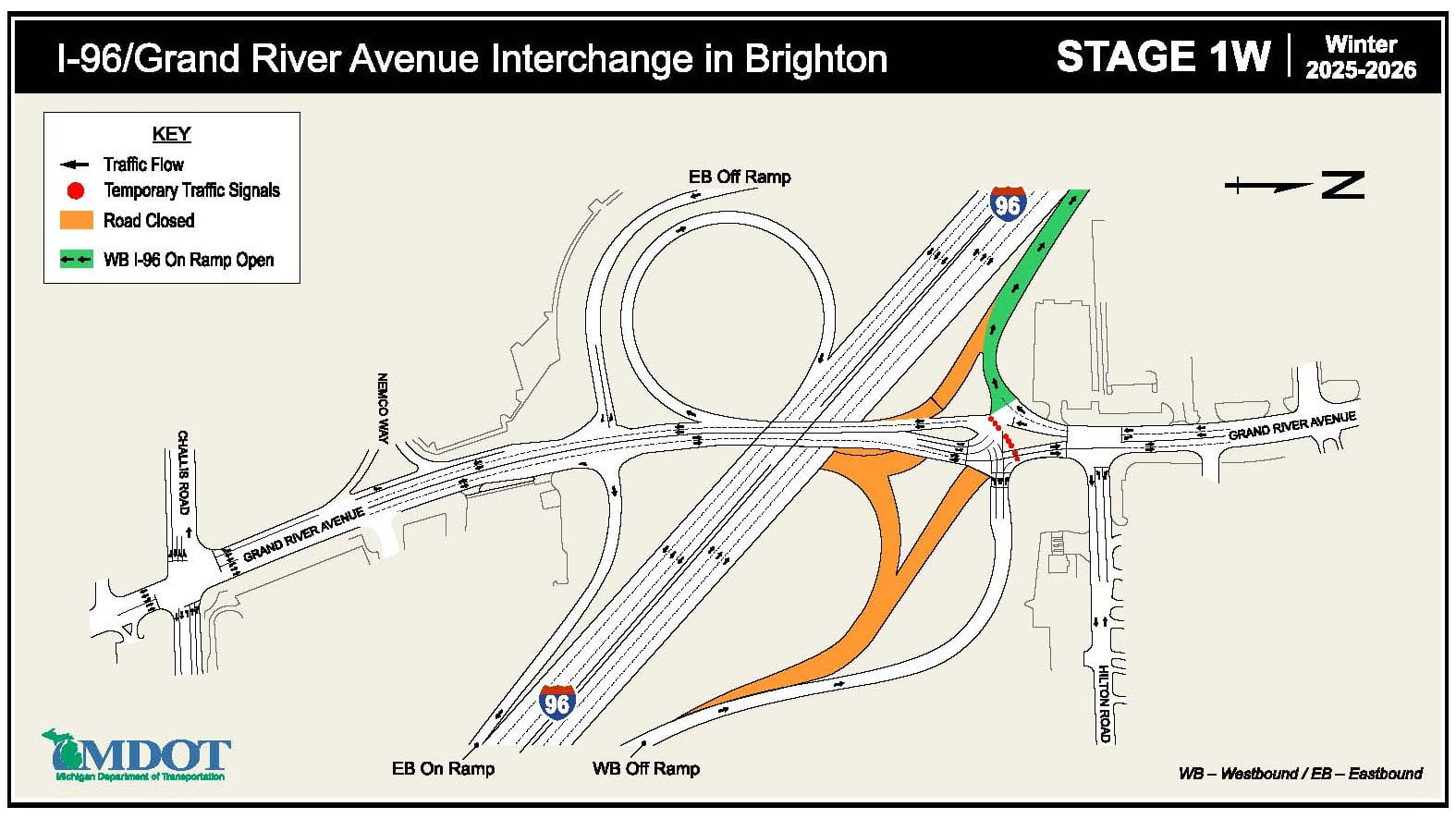

2025 Construction - Completed
- Rebuild westbound I-96.
- Two lanes of eastbound and westbound I-96 traffic will be maintained on eastbound I-96.
- Close the Grand River Avenue ramp to westbound I-96. Detours are:
- Westbound Grand River Avenue to eastbound I-96, then Spencer Road to westbound I-96.
- Eastbound Grand River Avenue to the eastbound I-96 ramp, then Spencer Road to westbound I-96
- Rebuild westbound I-96.
-
2024 Construction - Completed
In fall 2024, MDOT completed temporary crossovers on the freeway.
Project construction and detour maps
Stay connected
Media questions? Contact Aaron Jenkins, Media Representative, at 517-243-9075.
